Millwright Done Right: Emergency Removal of Damaged Conveyor System

INDUSTRY

Agricultural Commodities

EQUIPMENT USED

  • DB Beaver
  • DB Sea Horse (Hickey Marine)
  • 60’ manlift
  • 40’ manlift
  • 12K reach lift (x2)
  • 5K reach lift

At Terminal 5 of the Port of Portland, one of the conveyors that feeds Portland Bulk Terminals’ ship loaders suffered a catastrophic failure. The conveyor was unsafe to operate, and as a result, Portland Bulk Terminals was unable to load out vessels bound for ocean voyages. Portland Bulk Terminals required an emergency demolition of the conveyor. The demolition needed to happen quickly to keep Terminal operations running—and to keep them running safely.

Enter Omega Morgan’s Portland millwright services team. They mobilized within days to begin the careful and strategic planning this unique project required.

INDUSTRIAL MILLWRIGHT SERVICES BY THE EXPERTS

At first, the full extent of the failure wasn’t apparent. The conveyor structure was a series of 95’ bridge spans that weighed 130,000 lbs each. Because of bridge spans’ age, degradation, and the failure itself, it was difficult to know how strong the remaining spans were. Omega Morgan’s millwright team consulted several specialized engineers to develop a sound lifting and handling plan for safely removing all of the broken conveyor sections. All in all, our team of eight millwright specialists would need to remove eight of the concrete bridge spans, and seven concrete support bents.

A SAFETY-FIRST APPROACH TO MILLWRIGHT SERVICES

The first thing our millwright crew had to do was establish safe access to the dock. This involved erecting shorting towers under the first bridge span so the electrician could safely access the electrical control room—the electrical demolition was the first step in the overall demolition process.

Once that was completed, the Omega Morgan crew stabilized the broken conveyor section and removed all loose or suspended components. Once these two critical parts of the project were done, the major removal work could begin safely.

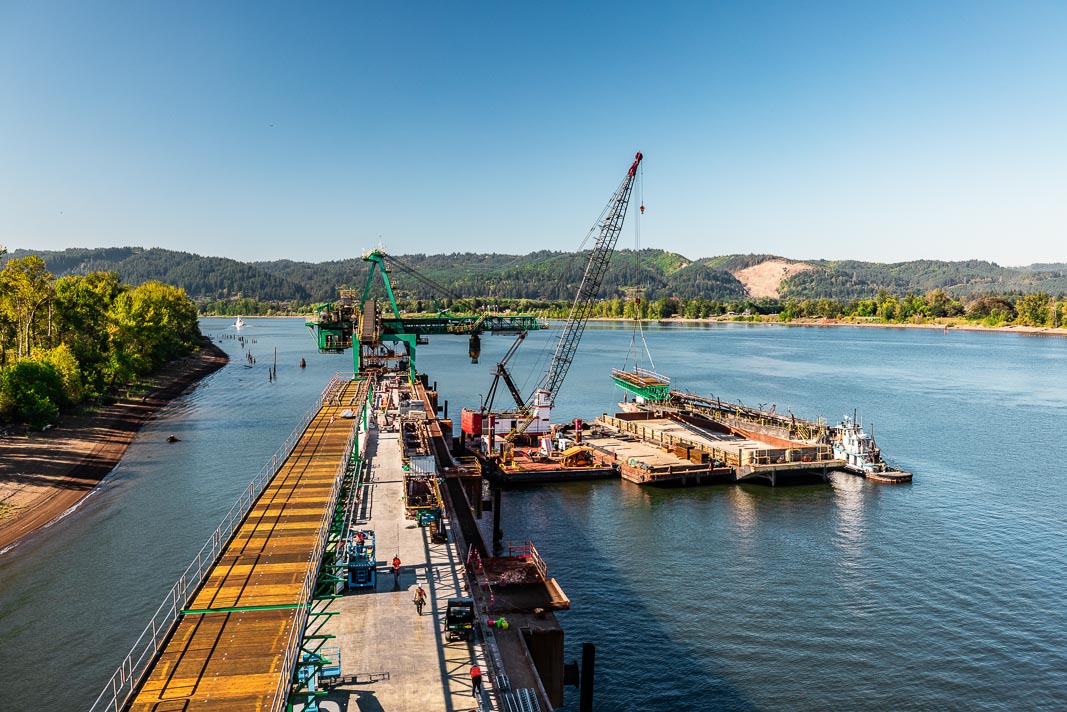

Our millwright crew removed the conveyor belts, then the conveyor frames, and finally the handrail. The conveyor spans were unseated from their pedestals using hydraulic jacks. They were then removed to a barge using two barge-mounted cranes.

This job had rather unique challenges and circumstances; the bridge spans were pre-stressed concrete, which have very particular requirements for safe handling. Additionally, these lifts required a two-crane pick, which our millwright team completed using two barge-mounted cranes.

MILLWRIGHT DONE RIGHT: SAFETY, PRECISION, AND EFFICIENCY

After all 14 components were safely removed, our millwright crews also provided extensive cleanup for Portland Bulk Terminals. They were extremely happy with our work: our millwright services team got the job done three weeks ahead of schedule, with zero safety incidents—true to the Omega Morgan way.

Foundation First: Installing a Dewatering Plant Foundation in Scappoose OR

Industry Construction

Equipment Used Excavator, 10K reach forklift, 60M concrete boom truck

Description When our client’s dredge dewatering system needed to be moved half a mile away to clear the dredging path, Omega Morgan’s millwright team installed one of our largest concrete foundation projects to date — 500 cubic yards — in less than four weeks.

Full Case Study

Installing a New Rebar Storage Table for Cascade Steel

Industry Steel

Equipment Used 12K Reach Forklift, Overhead Bridge Crane

Description Omega Morgan’s millwright services team worked with speed, safety and efficiency to install a new rebar storage table for Cascade Steel Rolling Mill.

Full Case Study

Spout Removal and Rebuild at an International Grain Terminal

Industry Grain Export

Equipment Used 100 Ton Derrick Barge, material barges, 180 foot man lift, 150 foot man lift, 10K reach forklifts, machine shop

Description Our Portland-based millwright services crew was asked to assist with a damaged grain spout at Kalama Export in Kalama, WA. Our team moved fast and worked diligently to remove and rebuild the unstable spout--getting the international grain terminal back up and running quickly.

Full Case Study

Clearing a Warehouse Space in the Coffee Industry

Industry Restaurant

Equipment Used 20K warehouse forklifts, 8K warehouse forklifts, scissor lifts, man lifts, torch sets, hand tools, industrial cranes

Description As part of an acquisition of Boyd’s coffee brand and equipment, Farmer Brothers needed to remove more than 200 heavy pieces of equipment and 550 tons of recycled metals and waste from a warehouse. For help with such a complex project, they turned Omega Morgan to do the job quickly and effectively.

Full Case Study

Returning a Portland Warehouse to its Original State

Industry Solar

Equipment Used 30K warehouse forklifts, 15K warehouse forklift, IC-200 Broderson Carry Deck, 40’ Manlifts, Excavator & Hoe-ram, 35 Ton Boom Truck

Description Omega Morgan’s Millwright team helped GCL Growers move out of a warehouse in Portland. Using a variety of tools ranging from forklifts and manlifts to an excavator and a boom truck, we demolished, moved, cleaned, and even recycled. In this case study we discuss Omega Morgan’s invaluable work on this project.

Full Case Study

Moving a Suction Dredge in Scappoose Oregon

Industry Construction

Equipment Used 150 Ton Lattice Boom Crawler Crane, Grove RT760 Hydro Crane

Description Omega Morgan provided crane assistance, operators, and millwrights to help receive, assemble and move a suction dredge in Scappoose, Oregon. Our teams worked with CalPortland and Dredging Supply Company to safely and efficiently assemble and move this nearly two million pound apparatus from land to water. In this case study we explain Omega Morgan’s work in this two-month assembly and colossal move.

Full Case Study

Ship Loader Grain Delivery Spout

Industry Grain / Port

Equipment Used Derrick Barge Crane, Tugging Service, Scaffolding Service, (1) 150’ Manlifts, Welders

Description Omega Morgan’s Portland- Millwright Services Division was contacted by Kalama Export, an international grain terminal in Kalama, WA to fix an underperforming articulating grain spout. The complex fix required an ocean-going barge and tug service, scaffolding, a 150’ manlift, welders, and a derrick barge crane. In this case study we outline how our industrial millwright services crews diagnosed the problem with the spout, and safely performed a long-term solution.

Full Case Study

Cascade Steel Mill Ladle Turret Replacement Case Study

Industry Steel

Equipment Used Tadano ATF 160G (200 Ton Crane), Full Counterweight, Kamag K25 PST 10-Axle Line Towable Hydraulic Platform Trailer, T-800 Kenworth Prime Mover, Aspen 90-Ton Lowbed, Peterbilt 379 Heavy Haul Tractor

Description We partnered with Cascade Steel Mills for a major steel mill ladle turret replacement project. The steel mill ladle turret weighed 62.5 tons and we moved it nearly 200 miles from Tacoma, WA to McMinnville, OR where it was installed. In this case study we outline how we accomplished this task, what equipment we used and how we tackled the moving and installation process.

Full Case Study

Export Dock Maintenance & Millwright Services

Industry Grain Export

Equipment Used 100 Ton Barge Mounted Derrick Crane, Materials Barge, Tugboat, (2) 150’ Manlifts, 12K Reach Forklift, Diesel Welders

Description Our experienced millwright services team was asked to assist a valuable client in the Grain Export industry with installing a new catwalk during their annual dock and ship loader maintenance project. In this case study we discuss how we successfully planned the project in and amongst other projects and dependencies, and how we executed flawlessly the work within our allotted time frame.

Full Case Study
